DeepSeek-V4-Flash Shock! The Inference Cost Deflation Shock and the Structural De-Rating of U.S. AI Infrastructure
1. Executive Summary: The "Cost Deflation Shock" in AI Infrastructure
The commercial release of frontier-grade, highly efficient AI architectures such as DeepSeek-V4-Flash--offering advanced agentic performance at $0.14 per 1M input tokens and $0.28 per 1M output tokens--signals a structural inflection point in the economics of artificial intelligence infrastructure. Representing a ~98% cost reduction relative to legacy Western frontier model APIs, this pricing paradigm is anchored in a cost-recovery operating philosophy targeting a 10-month capital payback horizon rather than the extraction of sustained monopolistic rents. Enabled by sparse Mixture-of-Experts (MoE) routing that activates approximately 13 billion parameters per token pass alongside native FP4/FP8 quantization-aware training, these architectures prove that enterprise-grade intelligence can be executed losslessly on localized, standard hardware footprints.
This architectural shift exposes a severe structural mismatch across the U.S. artificial intelligence capital allocation ecosystem. Over the preceding 36 months, global data center capital expenditure has scaled toward an estimated $750 billion annually by 2026 1, underwritten by the core assumption that centralized, hyper-dense GPU clusters would command durable pricing power and elevated rental yields. Over 23 gigawatts (GW) of data center IT capacity are currently under construction globally1, with all-in AI site development costs--inclusive of high-density liquid cooling, high-voltage electrical infrastructure, and GPU hardware fit-out--reaching $30 million to $40 million per megawatt (MW)2.

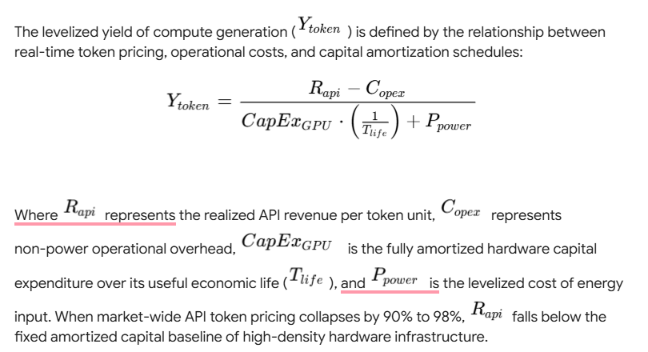

The rapid collapse of API token pricing fundamentally undermines the unit economics supporting U.S. Gigawatt-scale AI megaprojects ($3 billion to $5 billion per site shell; $30 billion to $40 billion fully fitted per GW)2. As token generation costs plummet, the underlying revenue streams of hyperscalers and specialized GPU cloud providers ("neoclouds") face immediate margin erosion. Fixed, long-term Power Purchase Agreements (PPAs) and 10-to-15-year site lease commitments risk transforming into unamortizable, non-performing liabilities. Concurrently, NVIDIA's ~80% gross margin structure faces severe headwinds as enterprise procurement pivots from mega-cluster capital expenditure toward right-sized, localized, and edge-hybrid deployment models.
|
Strategic & Economic Metric |
Legacy Frontier Model Regime |
DeepSeek-V4-Flash Paradigm |
Structural Economic Impact |
|
API Token Pricing (Input/Output per 1M) |
$2.50 / $10.00+ |
$0.14 / $0.28 |
~98% cost deflation in token revenue yields |
|
Model Architecture & Compute Draw |
Heavy Dense (100B-1T+ Active Parameters) |
Sparse MoE (~13B Active Parameters) |
8x-10x reduction in active compute parameter overhead |
|
Quantization & Execution Precision |
FP16 / FP8 Standard |
Native FP4 / FP8 Quantization-Aware |
Removes High-Bandwidth Memory (HBM) supply bottlenecks |
|
Target Infrastructure Footprint |
Ultra-dense Centralized GPU Megaclusters |
Localized / Enterprise Edge / Hybrid Racks |
Decouples model intelligence from massive physical cluster scale |
|
Implied GPU Payback Period |
18-24 Months |
8-10+ Years (at deflated yield rates) |
Destroys unit economics for debt-financed GPU clouds |
2. The Rent-Yield Collapse
Token Pricing Erosion and Neocloud Revenue Degradation
The fundamental unit economics of specialized GPU cloud infrastructure providers (e.g., CoreWeave, Lambda Labs) and traditional hyperscale cloud platforms (AWS, Azure, Google Cloud) are anchored directly to the monetization yield of raw compute capacity. Compute monetization occurs either through direct cloud instance rental ($2.00 to $3.50 per GPU-hour for NVIDIA H100 systems) or indirectly via token generation metrics across hosted model APIs.
Neocloud business models rely on acquiring high-density GPU fleets through debt financing facilities and leasing them to enterprise customers under fixed-term Master Service Agreements (MSAs)--typically averaging four years in duration with 15% to 25% upfront customer prepayments4. CoreWeave, for example, expanded its top-line revenue to $1.915 billion in 2024, yet $1.2 billion (62%) of this revenue was concentrated in a single hyperscale commitment4. As open-weights, highly efficient models enable enterprise tenants to achieve equivalent agentic throughput at a fraction of the compute footprint, enterprise willingness to lock into multi-year GPU cluster rentals degrades rapidly. As initial four-year contracts mature, re-contracting rates face severe downward pressure, extending capital payback timelines beyond the 3-to-4-year useful economic life of the silicon.
Toxicity of Long-Term PPAs and Site Leases
To guarantee power capacity for large-scale AI deployments, data center developers and operating tenants have entered into 10-to-15-year wholesale site leases and Power Purchase Agreements (PPAs)1. These fixed commitments were underwritten under the assumption of elevated tenant capacity utilization rates and sustained high rental pricing per kilowatt (kW).
In primary North American data center markets, shell-and-core construction costs average $7 million to $12 million per MW 3, while fully fitted AI facilities requiring direct liquid cooling and dedicated electrical substations range from $20 million to $40 million per MW 2. Operating expenses for these facilities--comprising industrial electricity rates, grid transmission charges, and mechanical overhead--run between $10 million and $25 million annually for mid-sized sites 3, with large-scale 100 MW campuses incurring annual energy bills ranging from €44 million to €149 million depending on market structures and Power Usage Effectiveness (PUE) performance 8.
The structural danger of these long-term commitments lies in the sharp divergence between fixed contract liabilities and deflating variable revenues. Data center operators remain legally bound to long-term industrial power contracts ($0.08 to $0.12 per kWh) and capacity reservation fees (such as PJM grid auction fees reaching $333.44 per MW-day)9. When tenant token monetization contracts by 90%+, the net cash flows generated by the compute hosted within these facilities can no longer cover the fixed facility operating costs and PPA obligations. Consequently, Debt Service Coverage Ratios (DSCR) fall below the 1.0x threshold, converting long-term PPAs and master leases into non-performing liabilities that threaten operators with structural insolvency.
3. The NVIDIA Margin Compression Cascade
Architectural Efficiency and Obsolescence of Hyper-Dense Clusters
The deployment of sparse MoE models executing natively in low-precision FP4 and FP8 formats dismantles the premise that frontier AI scaling requires ever-larger, tightly integrated GPU clusters linked by proprietary interconnect fabrics. DeepSeek-V4-Flash demonstrates three critical architectural efficiencies that alter hardware demand:
- High-Bandwidth Memory (HBM) Uncoupling: Native FP4/FP8 quantization-aware execution reduces the required memory footprint per active parameter by 50% to 75%. This enables high-parameter models to operate within standard memory boundaries, bypassing the severe HBM3e supply bottlenecks that previously drove premium hardware valuations.
- Interconnect Density Reduction: Routing execution through ~13 billion active parameters per token drastically reduces cross-node collective communication intensity (specifically AllReduce and AllToAll operations). This diminishes the necessity for expensive, ultra-high-speed NVLink switching fabrics and Quantum-2 InfiniBand networking topologies.
- Localized Enterprise Offloading: Enterprise inference workloads can be offloaded from centralized hyperscale clusters and executed locally on hybrid multi-GPU enterprise servers or edge appliances without loss of agentic performance.
These architectural advancements decouple model intelligence from physical cluster density. As a result, enterprise procurement strategies are pivoting away from multi-thousand-GPU orders (e.g., 24,000 to 100,000 tightly coupled units) toward rightsized, localized clusters engineered specifically for sparse MoE execution.
Destruction of NVIDIA Scarcity Premium and Gross Margins
NVIDIA's corporate gross margins (~80% at peak cycle) reflect a scarcity premium generated by intense enterprise demand for turnkey AI compute systems (such as the DGX/HGX H100 and B200 NVL72 platforms). NVIDIA captured unprecedented economic rent by bundling accelerator silicon with proprietary high-margin Mellanox networking assets and the CUDA software ecosystem.
As enterprise infrastructure requirements pivot toward localized, right-sized deployments, NVIDIA's pricing power faces headwinds across three primary dimensions:
- Average Selling Price (ASP) Decay: Margins on fully integrated, liquid-cooled rack systems face downward pressure as enterprise buyers re-evaluate the return on investment (ROI) of top-tier hardware configurations in favor of modular, lower-cost setups.
- Networking Unbundling: Reduced reliance on hyper-dense compute fabrics diminishes demand for proprietary NVLink switches and InfiniBand host channel adapters, accelerating the market shift toward open-standard Ethernet solutions engineered under the Ultra Ethernet Consortium.
- Custom ASIC Substitution: Deflated inference token yields force hyperscale cloud operators to shift workloads onto internal custom ASICs (e.g., AWS Inferentia, Google TPU, Microsoft Maia), reducing the market share of general-purpose GPUs in routine inference workloads.
As the industry transitions from capital-insensitive model training to cost-sensitive inference execution, NVIDIA's gross margins are projected to contract from ~80% back toward historical semiconductor industry averages of 50% to 60%, driving a structural re-rating of its equity valuation multiple.
|
Hardware & Silicon Dimension |
Scarcity Peak (H100/B200 Peak Era) |
Post-Deflation Shock Regime |
|
NVIDIA Corporate Gross Margin |
~85% |
50% - 60% (Normalized Baseline) |
|
Primary System Sales Mix |
Tightly-Coupled NVL72 / HGX Racks |
Modular Standalone Accelerator Cards |
|
Networking Fabric Integration |
Proprietary NVLink / InfiniBand |
Open-Standard Ethernet / PCIe Fabrics |
|
Procurement Metric Focus |
Absolute Cluster FLOPS & HBM Capacity |
Levelized Compute Efficiency ($/Token) |
|
Custom ASIC Market Penetration |
Low (<15% of Hyperscale Workloads) |
High (>35%-50% of Production Inference) |
4. Structural Insolvency of U.S. AI Megaprojects
Capital Intensity, Debt Costs, and Grid Bottlenecks
U.S. Gigawatt-scale data center developments are constrained by elevated capital intensity and structural utility bottlenecks that magnify their exposure to compute price deflation. Developing a 1 GW AI megaproject requires an estimated $30 billion to $40 billion in total capital outlay2, with $3 billion to $5 billion required for shell, core, and primary electrical infrastructure prior to hardware installation3.
To finance these mega-developments, sponsors have relied heavily on private credit markets, delayed draw term loans (DDTL), and asset-backed securitizations carrying high interest rates4. Specialized GPU cloud providers face interest rates between 9% and 15% on non-recourse debt facilities4, creating substantial fixed debt service obligations that require continuous, high-margin asset utilization4.
Simultaneously, U.S. power grid constraints have introduced severe financial overhead:
- Capacity Auction Cost Surges: In primary grid regions like PJM, capacity auction clearing prices reached a record $333.44 per MW-day due to a regional 6.6 GW reliability shortfall9. For a 1 GW data center campus, this capacity reservation charge adds approximately $121.7 million in annual fixed operating expense before a single megawatt-hour of active power is consumed.
- Extended Interconnection Queues: Utility interconnection queues, regulatory permitting delays, and long lead times for specialized high-voltage transformers (18 to 36 months)12 extend full site commissioning timelines to 3-6 years2.
- Front-of-Meter Infrastructure Capital Requirements: Grid operators increasingly mandate that data center developers directly fund front-of-meter substation upgrades ($3 million to $10 million+)12 and network reinforcement costs, further inflating initial capital expenditure requirements.
Comparative Cost Disadvantage: U.S. Megaprojects vs. Global Alternatives
This capital-intensive, centralized approach contrasts sharply with international data center development and localized enterprise infrastructure models. Nordic markets, for example, offer lower wholesale electricity costs--such as Sweden at €40-€60/MWh compared to €130-€155/MWh in Dublin or Germany8--alongside lower grid access fees and streamlined regulatory frameworks8.
Concurrently, distributed enterprise architectures running sparse MoE models on localized infrastructure avoid grid interconnection queues entirely and eliminate private credit debt service costs. This leaves capital-heavy U.S. megaprojects with an uncompetitive cost baseline during periods of token price deflation.
|
Cost Component / Operational Metric |
U.S. Centralized AI Megaproject |
Nordic / European Regional Campus |
Localized Enterprise Edge Model |
|
All-in Construction CapEx (per MW) |
$30M - $40M2 |
$20M - $28M2 |
$3M - $6M (Incremental fit-out) |
|
Weighted Average Cost of Debt |
9.0% - 15.0% (Private Credit)4 |
4.5% - 7.0% (Corporate/Green Bond) |
4.0% - 6.0% (Corporate Revolver) |
|
Wholesale Electricity Cost Baseline |
$80 - $120 / MWh |
€40 - €60 / MWh8 |
Standard Commercial Tariff |
|
Grid Capacity Auction Overhead |
$333.44 / MW-day (PJM Zone)9 |
Minimal / Socialized Fee Structure8 |
None (Existing Service Infrastructure) |
|
Full Development Commissioning |
36 - 72 Months2 |
18 - 30 Months2 |
3 - 6 Months |
5. Wall Street Investment Implications
Hardware Manufacturers: Equity Downgrade Thesis
Public hardware manufacturers and semiconductor providers face inventory write-downs and downward earnings revisions as enterprise procurement shifts away from high-density compute architectures.
- NVIDIA Corporation (NVDA): Risk rating downgraded due to anticipated gross margin compression from peak ~80% levels down toward historical semiconductor norms (50%-60%), alongside slowing top-line revenue growth as hyperscalers adjust order books for dense cluster architectures.
- Server OEMs (Dell Technologies, Super Micro Computer): Operating margins face headwinds as the sales mix shifts from complex, high-margin liquid-cooled GPU rack architectures ($30M-$40M/MW equivalent)2 toward lower-margin, standardized enterprise servers. High-density server rack inventories risk obsolescence if enterprise buyers downsize cluster deployments.
Specialized AI Data Center REITs: Structural Exposure Warnings
Data Center Real Estate Investment Trusts (REITs) trading at elevated valuation multiples remain vulnerable to cash flow compression and cap rate expansion as underlying compute yields decline.
- Equinix (EQIX): Valuation metrics reflect premium pricing (P/AFFO of 38x-40x versus peer medians of 22x-26x)14. Despite operating cash flow of $3.9 billion, aggressive infrastructure CapEx ($5.3 billion) yields negative Free Cash Flow (-$1.4 billion) alongside $22.7 billion in total debt14. Equinix faces valuation compression if portfolio capitalization rates expand from current 4.4%-5.0% levels15 toward 6.5%-7.5% to reflect elevated tenant credit and re-contracting risks.
- Digital Realty Trust (DLR): Vulnerable to cash flow compression across its wholesale hyperscale portfolio as anchor tenants seek lower rental rates upon contract renewal to align with deflated compute monetization yields16.
GPU-Collateralized Private Credit: Impairment and Default Risk
The expansion of private credit facilities backed by GPU hardware collateral represents a concentrated credit risk across structured finance markets 10.
Specialized GPU cloud providers have secured billions in debt financing by pledging NVIDIA GPU fleets as primary collateral10. CoreWeave's capital structure includes a $1.0 billion Delayed Draw Term Loan (DDTL 1.0) at 15% interest4, a $3.84 billion DDTL 2.0 facility at 11% interest4, a landmark $7.5 billion debt facility led by Blackstone and Magnetar10, and a $2.6 billion DDTL 3.0 facility priced at SOFR + 4% maturing in 203013. These loans rely on first-lien pledges over GPU hardware4, with loan amortization schedules underwritten against negotiated hardware depreciation curves11.
The collapse of API token pricing accelerates the market value depreciation of H100 and B200 hardware ahead of established loan payoff schedules. As secondary market valuations for GPU collateral decline, Loan-to-Value (LTV) ratios risk breaching debt covenant thresholds (typically capped at 65%-75% LTV). Covenant breaches force borrowers to post additional cash collateral, execute equity cures, or face asset foreclosures, creating structural loss risks for private credit lenders and asset-backed security holders.
|
Private Debt Facility / Credit Instrument |
Total Commitments ($B) |
Stated Interest Rate / Yield |
Primary Pledged Collateral Base |
Credit Impairment & Risk Assessment |
|
CoreWeave Delayed Draw Term Loan 1.0 |
$1.00B4 |
15.0% Fixed4 |
First-Lien NVIDIA GPU Fleets4 |
Severe default risk; unsustainably high debt service burden4. |
|
CoreWeave Delayed Draw Term Loan 2.0 |
$3.84B4 |
11.0% Fixed4 |
First-Lien NVIDIA GPU Fleets4 |
Collateral coverage vulnerable to secondary GPU price deflation11. |
|
CoreWeave DDTL 3.0 Secured Facility |
$2.60B13 |
SOFR + 4.0%13 |
CoreWeave Compute Acq. VII Assets13 |
2030 maturity exposed to long-term contract re-pricing risks13. |
|
CoreWeave Standalone Term Loan |
$1.00B4 |
12.0% Fixed4 |
OEM Hardware & Cloud Systems4 |
High refinancing risk upon 2025 maturity4. |
|
CoreWeave OEM Equipment Financing |
$1.30B4 |
9.0% - 11.0%4 |
Server Racks & Supporting Fit-out4 |
Depreciating physical asset coverage relative to principal balance11. |
6. Strategic Conclusions and Capital Realignment
The emergence of hyper-efficient architectures demonstrates that algorithmic advancements can outpace physical infrastructure expansion. The economic assumptions that underwrote gigawatt-scale data center developments, high-density GPU cluster procurement, and elevated debt leverage require immediate re-evaluation. Capital allocation strategies across public equity and private credit markets should adjust to three core realities:
- Rebalancing Capital from Mega-Clusters to Distributed Inference: Institutional capital must pivot away from multi-billion-dollar centralized training megaprojects toward localized, flexible, and energy-efficient inference infrastructure engineered specifically for sparse MoE models.
- De-rating of GPU-Collateralized Private Credit and AI REIT Multiples: Debt facilities secured by rapidly depreciating GPU hardware face structural collateral impairment11, while specialized data center REITs trading at elevated P/AFFO multiples face valuation adjustments as capitalization rates expand to reflect tenant credit risks14.
- Normalization of Semiconductor Margins: NVIDIA's historic gross margin profile (~85%) faces long-term compression as enterprise buyers shift from scarcity-driven hardware purchases toward levelized compute cost efficiency, accelerating the adoption of alternative accelerator silicon and open-standard fabrics.
Institutional investors are advised to reduce exposure to capital-intensive, highly leveraged GPU cloud operators and specialized AI REITs, while prioritizing capital allocation toward energy-efficient, regionally flexible infrastructure providers capable of adapting to deflated compute yields.
引用文献
- AI Data Center Build Advances at Full Speed: Five Things to Know | BloombergNEF, https://about.bnef.com/insights/data-centers/ai-data-center-build-advances-at-full-speed-five-things-to-know/
- AI Data Center Construction 2026: Capex, Cost per MW, Delays | Archdesk, https://archdesk.com/blog/global-ai-data-center-construction-2026
- How Much Does a Data Center Cost? The Complete Guide To 2026 Price Breakdown, https://encoradvisors.com/data-center-cost/
- CoreWeave - Glenn K. Lockwood, https://www.glennklockwood.com/garden/entities/coreweave
- Cost of a Data Center | BlueCap Economic Advisors, https://www.bluecapeconomicadvisors.com/post/cost-of-a-data-center
- How Much Does It Cost to Build a Data Center? Key Factors & Breakdown - SILVRFISH, https://silvrfish.com/blog/how-much-does-it-cost-to-build-a-data-center/
- Total Cost of Ownership for Modular Data Centers vs. Traditional Builds - Inflect, https://inflect.com/blog/total-cost-of-ownership-for-modular-data-centers-vs.-traditional-builds
- AI Data Center Energy Cost Europe 2026: The Complete Market and Cost Guide, https://techplustrends.com/ai-data-center-energy-cost-europe-market-guide/
- AI & Data Center Energy 2026, 2,600 GW Queue & PJM Plan - EnkiAI, https://enkiai.com/data-center/ai-data-center-energy-2026-2600-gw-queue-pjm-plan/
- Who Owns CoreWeave Company? - Business Model Canvas Research, https://businessmodelcanvastemplate.com/blogs/owners/coreweave-who-owns
- GPUs as Collateral -- Chip Based ABS | by elongated_musk | Medium, https://medium.com/@Elongated_musk/gpus-as-collateral-chip-based-abs-acf55ac3f135
- Data Center CAPEX Calculator | Construction Cost Estimator, https://resistancezero.com/capex-calculator.html
- CoreWeave Closes $2.6 Billion Secured Debt Financing Facility, Strengthening Market Position as AI Cloud Leader, https://investors.coreweave.com/news/news-details/2025/CoreWeave-Closes-2-6-Billion-Secured-Debt-Financing-Facility-Strengthening-Market-Position-as-AI-Cloud-Leader/default.aspx
- Equinix, Inc. (EQIX) Stock Analysis & Key Metrics - KoalaGains, https://koalagains.com/stocks/NASDAQ/EQIX
- January 2025 - Investor Presentation, https://s28.q4cdn.com/669718746/files/doc_news/2025/01/Digital-Core-REIT-Investor-Presentation-Jan-2025.pdf
- Digital Realty Trust, Inc. - 10K - Annual Report - February 13, 2026 - Fintel, https://fintel.io/doc/sec-digital-realty-trust-inc-1297996-10k-2026-february-13-20497-5634
- Who are CoreWeave, the cloud provider that just used Nvidia chips to raise $2.3 billion?, https://capacityglobal.com/news/who-are-coreweave-the-cloud-provider-that-just-used-nvidia-chips-to-raise-2-3-billion/
- CoreWeave Secures $7.5 Billion Debt Financing Facility led by Blackstone and Magnetar, https://www.blackstone.com/news/press/coreweave-secures-7-5-billion-debt-financing-facility-led-by-blackstone-and-magnetar/
